Asphalt rehabilitation with EBS

We recycle the existing pavement in place and stabilise it with EBS, turning failing roads into durable, water-resistant structural layers with a design life of 15–20 years, without full reconstruction.

Discuss Your Road Download the Technical Brochure

15–20 yrs

design life

30–50%

lower upfront cost

Up to 90%

existing material reused

Typical values. Actual design life, savings and material reuse depend on material suitability, existing pavement condition, traffic requirements and drainage considerations.

Recycled asphalt: reuse the road you already have

A better option than remove and replace

Conventional rehabilitation breaks up the old pavement, hauls it away as waste and trucks in new aggregate and asphalt. It's slow, expensive and disruptive, and patching alone only treats the symptoms. Our approach starts by understanding why the road is failing, then reuses the material already in place to engineer a new, stronger pavement structure.

Two proven methods

CIR

Cold In-Place Recycling

For distress confined to the asphalt layer. The existing asphalt is milled, sized and remixed with EBS to a typical depth of 75–150 mm, then compacted and sealed.

FDR

Full Depth Reclamation

For distress that reaches the base. The full asphalt and base thickness, typically 150–300 mm, is pulverised and stabilised with EBS as one stronger layer.

How it works

1Reprocess in situ
The existing asphalt is milled and reprocessed to design depth using CIR or FDR equipment.
2Add and mix EBS
EBS is introduced at the specified dose rate and blended with water into a uniform, stabilised mix.
3Compact
The stabilised material is compacted to the required density for strength and structural performance.
4Surface seal with EBS
A durable, waterproof EBS seal completes the new pavement, without full reconstruction.
How it works: reprocess in situ, add and mix EBS, compact, surface seal with EBS

In the field

A single continuous recycling train reprocesses, stabilises and compacts the road in one pass, so roads return to service sooner, with far fewer truck movements.

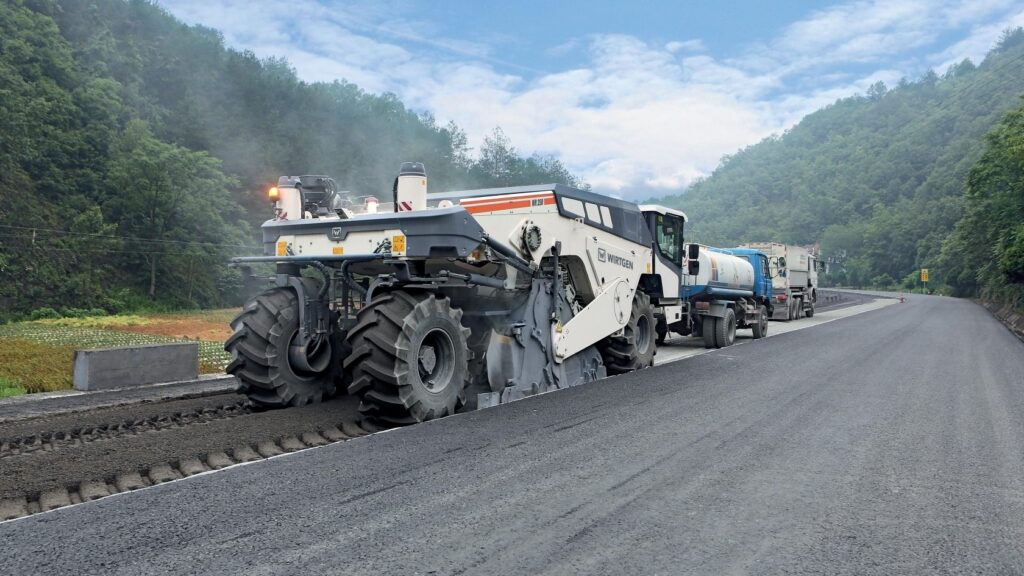

Road recycler reprocessing asphalt beside the finished, newly surfaced lane

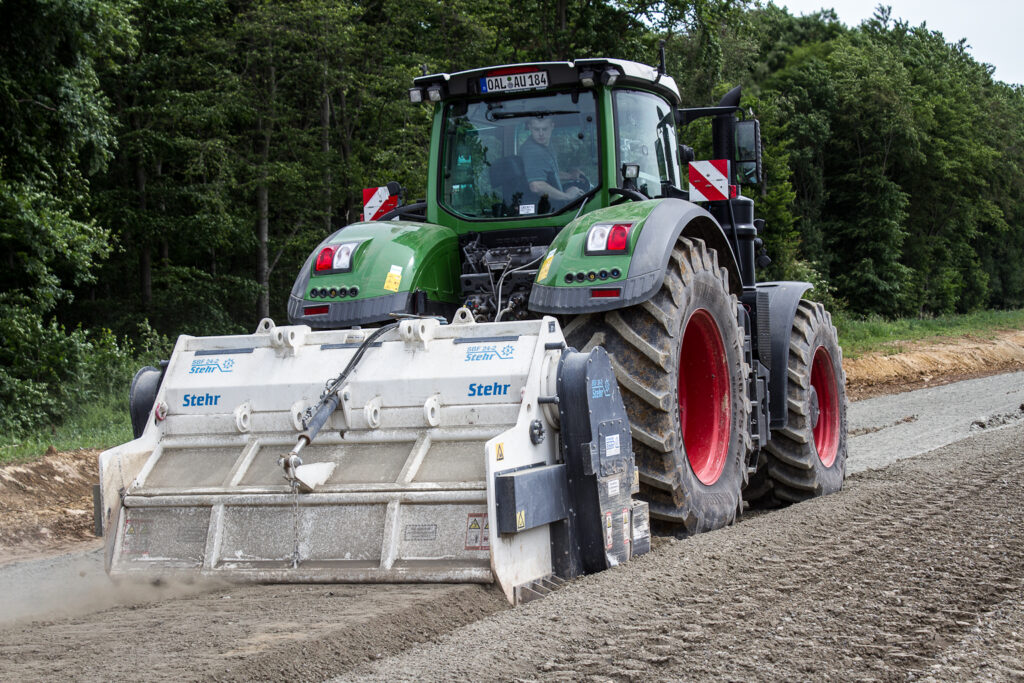

Road recycler with water tanker working an unpaved road Tractor-mounted stabiliser milling existing asphalt in place Recycling train rehabilitating a mountain road

Why recycle with EBS

Greater performance. Lower lifecycle costs.

Faster construction, minimal disruptionReduced downtime with rapid in-place rehabilitation.
Crack prevention by designEliminates reflective, fatigue and thermal cracking through a unified structural layer.
Enhanced structural strengthHomogeneous mixing improves load distribution and bearing capacity.
No full pavement removalExisting material is reused, eliminating waste and disposal costs.
No additional aggregate importsUses in-situ materials for a more sustainable solution.
Improved drainage and profile controlSlope and surface geometry are corrected during rehabilitation.
Up to 30–50% lower upfront costsTypical savings compared with conventional reconstruction, depending on site conditions.
Reduced maintenanceLong-term lifecycle savings through improved durability.
Greater flexibility and fatigue resistanceA more resilient surface that performs under repeated loading.
Asphalt EBS comparison: before, in-process and after recycling with EBS

The technical detail

For engineers and specifiers: failure mechanisms, method selection, pavement structure and project screening.

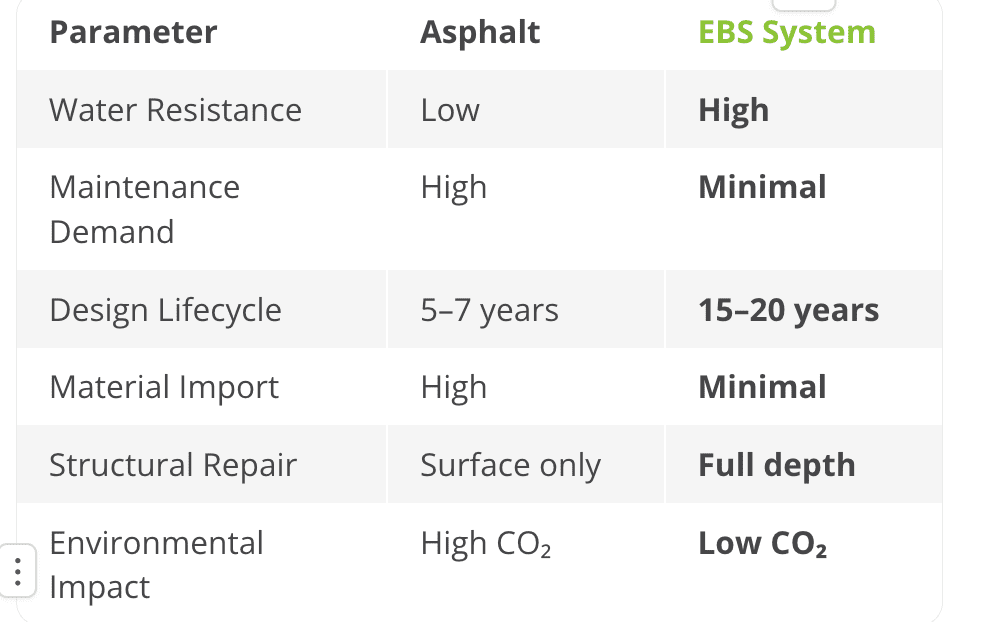

Conventional asphalt vs EBS at a glance
ParameterConventional asphaltEBS system
Water resistanceLowHigh
Maintenance demandHighMinimal
Design lifecycle5–7 years15–20 years
Material importHighMinimal
Structural repairSurface onlyFull depth
Environmental impactHigh CO₂Low CO₂
Asphalt vs EBS comparison

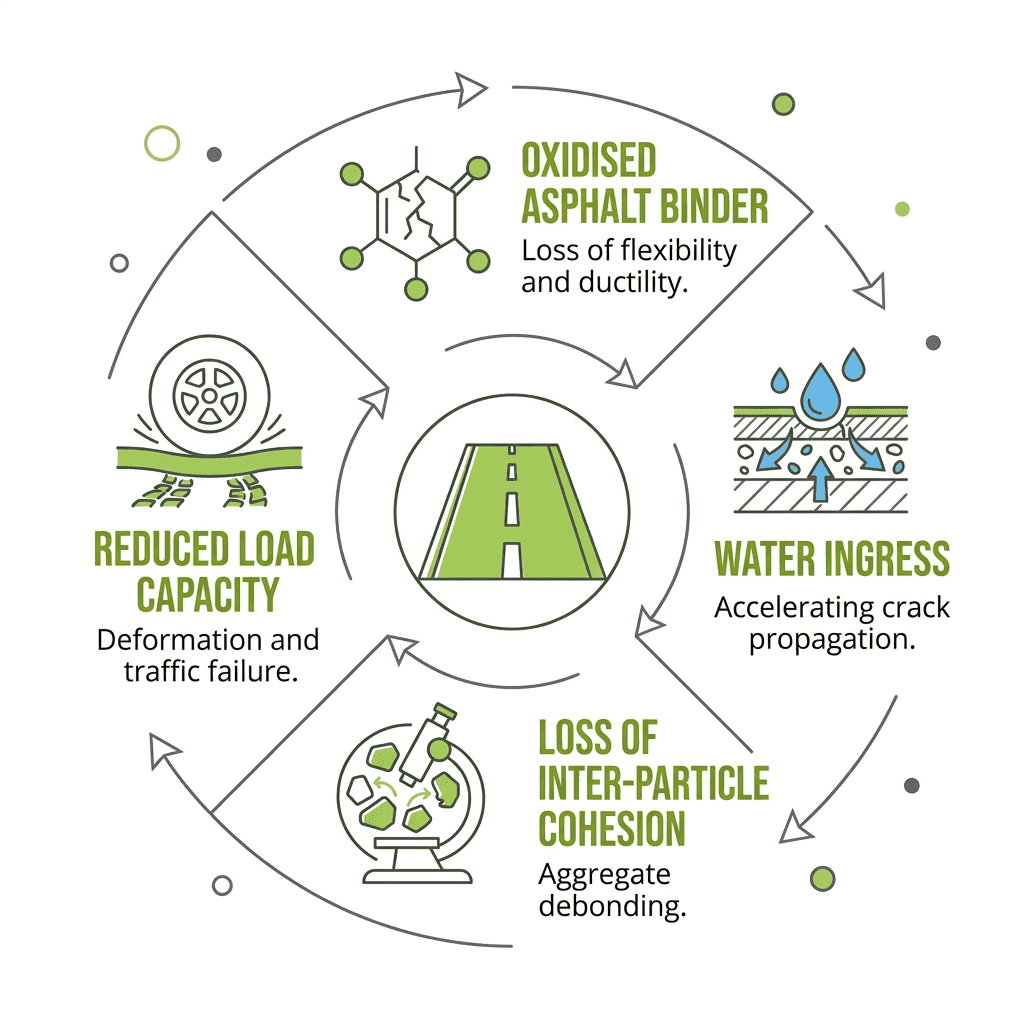

Why asphalt roads fail


The visible surface defect is only the starting point. Weak subgrade support, water ingress and repeated traffic loading together decide the right treatment depth and method. The four most common failure types:

  • Cracked and oxidised asphalt: ageing and oxidation cause loss of binder flexibility, making the surface brittle and prone to cracking and ravelling.
  • Patchwork surfaces: repeated minor repairs create inconsistent layers with varying material properties, weak joints and poor ride quality.
  • Structural degradation: water ingress, heavy axle loads and deferred maintenance reduce stiffness, causing fatigue cracking, rutting and base deformation.
  • Drainage-related failure: poor drainage saturates the base and subgrade, accelerating potholes, edge break and loss of structural support.

Patching alone treats the symptom, not the cause, and each repair cycle costs more than the last. Lasting rehabilitation means treating the failure mechanism.

Assessment comes first


A structured investigation confirms the nature and depth of distress before any treatment is selected. Accurate diagnosis prevents under-design: pavement analysis → investigation and testing → treatment selection → implementation.

Surface preservation is enough when

  • Only minor cracking or oxidation
  • Base and subgrade are stable and well-drained
  • Deflection testing confirms structural capacity
  • Traffic loading is within design parameters

Deeper treatment is needed when

  • Alligator cracking or rutting is present
  • The base or subgrade is saturated
  • Cores show loss of bond or delamination
  • Repeated patching has failed to hold


Where the base is sound, an EBS surface seal can protect the pavement against moisture and UV oxidation at a fraction of the cost of full rehabilitation.

Choosing CIR or FDR

Cold In-Place Recycling (CIR)

Treats the existing asphalt layer, typically 75–150 mm deep. The material is blended with EBS and water in a single continuous train, then compacted and shaped.

Key design inputs:

  • Existing asphalt gradation and binder content
  • Lab-determined EBS dose rate
  • Optimum moisture content
  • Target density and compaction method
  • Overlay needs based on traffic

Full Depth Reclamation (FDR)

Used when distress extends into the aggregate base. FDR treats asphalt plus base, typically 150–300 mm in total, as one stronger stabilised layer.

  • Correct drainage first: FDR can't compensate for ongoing water ingress
  • Lower subgrade stress: the treated layer spreads load, cutting subgrade stress from around 20 psi to about 5 psi in typical designs
The stabilised pavement structure
EBS surface seal (3–5 mm)Sealed, waterproof wearing layer that controls runoff and protects against moisture and UV
Stabilised layer (75–100 mm)Regenerated asphalt with EBS, densely mixed and compacted for high strength and load-bearing capacity
Reworked baseExisting aggregate base, reworked and compacted for uniform support
Compacted subgradeIn-situ material compacted to specification, with a 2–4% cross-fall to defined side drains


Because the layer is rebuilt as one unit, there are no layer interfaces for old cracks to reflect through. An asphalt overlay is optional, depending on traffic, design life and smoothness requirements.

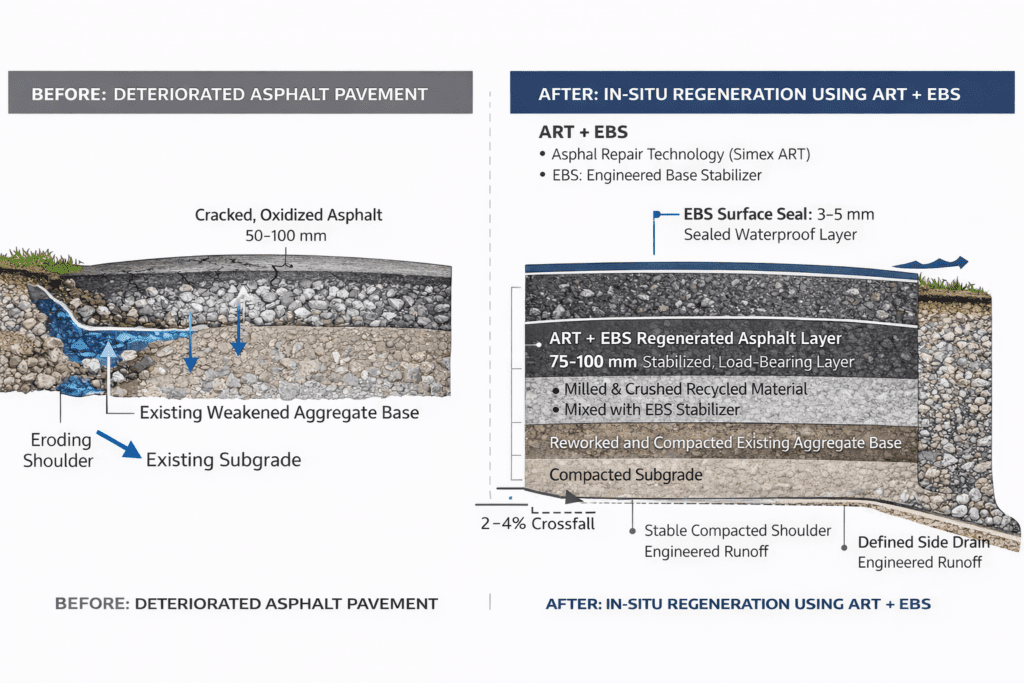

Before and after pavement cross-section: deteriorated asphalt versus in-situ regeneration with EBS

Cross-sections are illustrative. Actual performance is governed by site-specific testing and mix design.

How EBS works in reclaimed asphalt


EBS targets the two main failure drivers: loss of inter-particle cohesion and moisture sensitivity.

  • Improved cohesion: re-establishes the bond between aggregate particles and residual binder
  • Moisture resistance: the treated layer becomes far less water-sensitive, resisting the saturation that caused the original failure
  • Increased stiffness: better load distribution and fatigue resistance
  • Material retention: usable aggregate and residual binder stay in the road, with no virgin aggregate needed for the structural layer
Is your road a good candidate?

Strong candidates

  • Asphalt cracking or oxidation with an intact base
  • Base failure with correctable drainage
  • Enough layer thickness for the design depth
  • Material gradation within the stabilisation range
  • Traffic loading compatible with the recycled layer

Needs further review

  • Very thin asphalt (<50 mm) under heavy loading
  • Highly contaminated or organic subgrade
  • Drainage problems that can't be corrected
  • Binder chemistry incompatible with EBS
  • Utilities preventing the design treatment depth
Start with a pilot section


Testing a representative segment turns engineering judgement into measured performance data before you commit to a full programme.

  • Select: a section typical of, or slightly worse than, the wider network
  • Record: density, EBS dose rate, moisture content, compaction passes and surface profile
  • Monitor: rutting, cracking, moisture response and maintenance over 12–24 months
  • Decide: use the measured results to justify the full rehabilitation programme
Technical specifications
Stabilisation pass1.0–1.5 L/m² EBS, depending on material condition
Surface seal0.35 L/m² EBS, forming a 3–5 mm sealed waterproof layer
Total application rate1.35–1.85 L/m²
CIR treatment depthTypically 75–150 mm
FDR treatment depthTypically 150–300 mm (asphalt plus base)
Stabilised layer75–100 mm regenerated asphalt with EBS
Cross-fall2–4% to defined side drains
EquipmentReclaimers, road recyclers or soil stabilisers, with compaction plant
CompactionCompacted to the required density, as specified in the project mix design
Design life15–20 years with proper mix design, compaction and drainage
EU regulatoryREACH exempt (Article 2(9) polymer exemption)

Final dose rates, depths and mix design are confirmed for each project through site assessment and laboratory testing.
